Enterprise aviation

Ground operations that teams can verify

On the ramp, a single operation passes between the field crew and the manager: the work happens on a phone, while the status and the history are needed on the web. Without explicit states, a record can look finished before the work is. In GroundOps and Inspections I separated preparation, unknown data, completion and the problems that stay open after an inspection. The cost of a missed step: damage to an aircraft, or work with faulty equipment.

Role

Product Designer · Axel

External team for NDX

Timeline

2021–2026

From the start of the project to the end of my involvement

Platforms

Web · iOS · Android

Phone and tablet

NDX GroundOps: ramp overview on the web and the mobile tail-number search screen with active movements

GroundOps + Inspections

Two products for business aviation ground teams

In production

1/3

of Signature's US locations were working with Inspections

As of the announcement in October 2024. Signature selected the product for a network-wide rollout across the US. A result of the whole team.

Read the announcement ↗
Navigation

2 decisions

this case is built on

01

A field test changed the direction

Collision Prevention was part of the early Ramp, the future GroundOps. Beacons on the extremities of the aircraft were meant to send the distance to an obstacle to a phone. City tests looked convincing, but on an active ramp the signal proved unreliable. The product team and the engineers stopped the hardware direction.

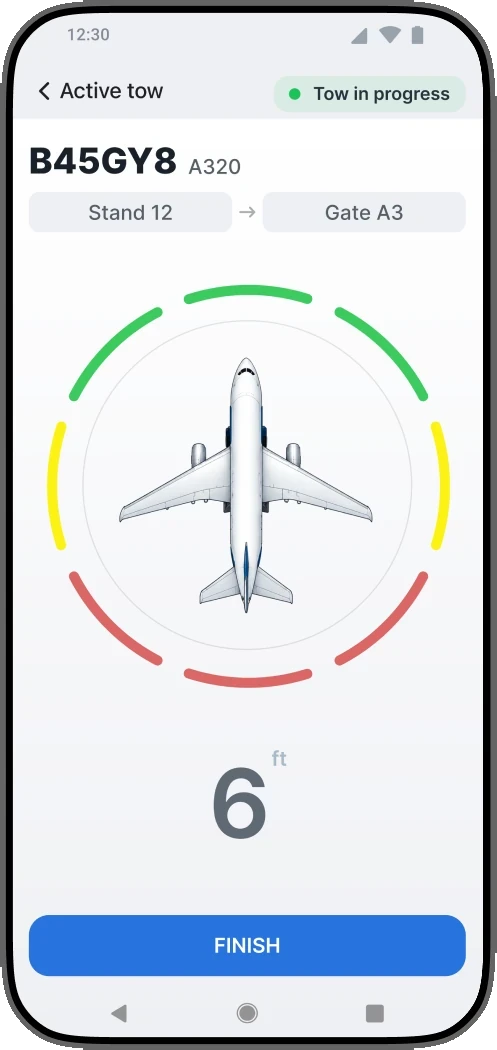

Early Collision Prevention concept: a circular distance indicator around the aircraft, 6 feet to the object

Early concept, 2021.

After the pivot

Preparing and recording a tow

In the later work on GroundOps I tied the crew's actions to the state of the operation. Phone positioning helped show the location, and people confirmed that the steps were done.

My decision

Designed the checks, the destination choice, the crew composition and the completion as parts of one tow: on the phone and on the web.

Trade-off

Confirmations cost the employee time. They record the steps that were completed, but they do not replace a distance sensor.

Where I was wrong

I treated the technology's feasibility as already proven

The team worked on the hardware hypothesis for about six months. I started detailed design work before the technology was tested on an active ramp. The reliability and stop criteria should have been agreed earlier; part of the states and roles I worked out later proved useful in GroundOps.

02

A tow: from preparation to completion

The employee chooses the destination, goes through the checks and confirms the crew. The manager needs to see which tow is running and when it is finished. I connected preparation, movement and completion to one operation.

Tow flow

01

Choose the destination

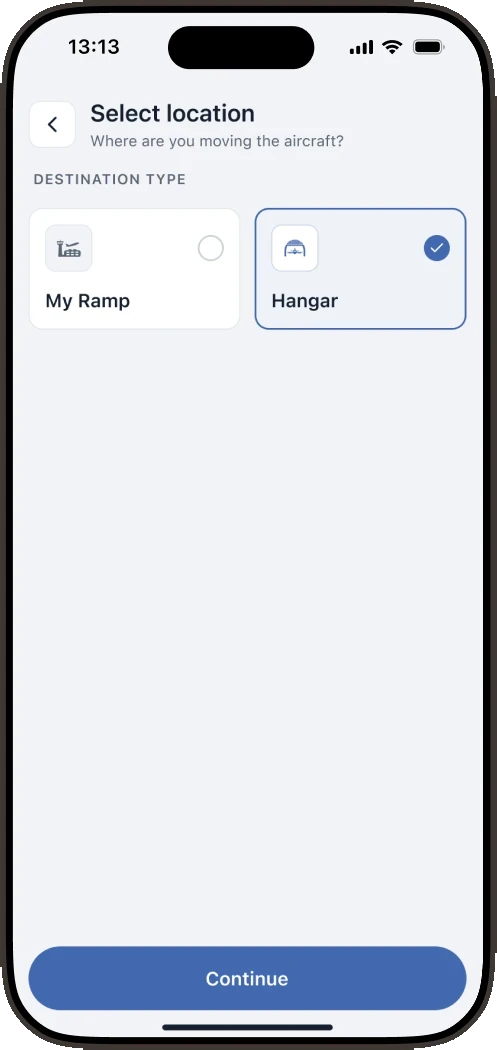

Select location: choosing the destination type, My Ramp or Hangar, before towing B45GY8

Destination.

02

Check the aircraft

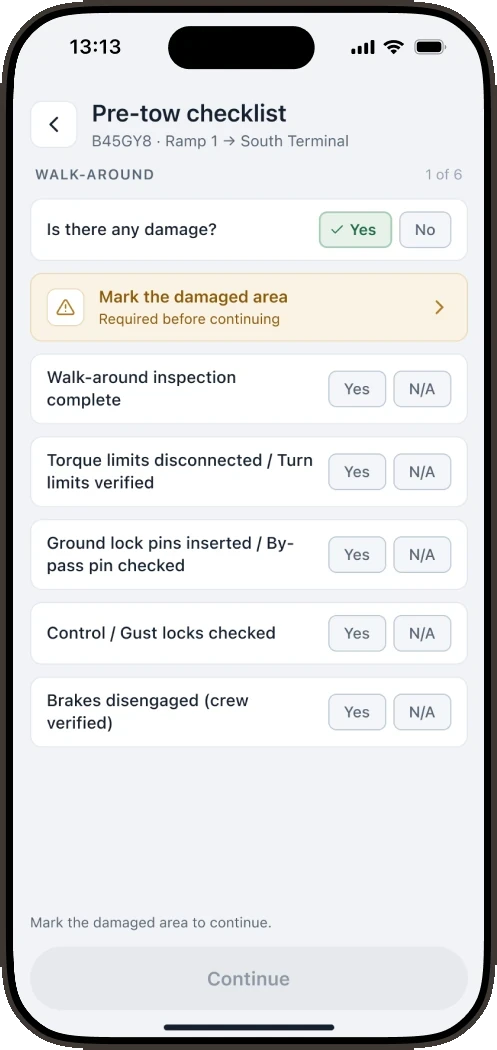

Pre-tow checklist: walk-around, damage and equipment checks before the tow

Walk-around and checks.

03

Confirm the team

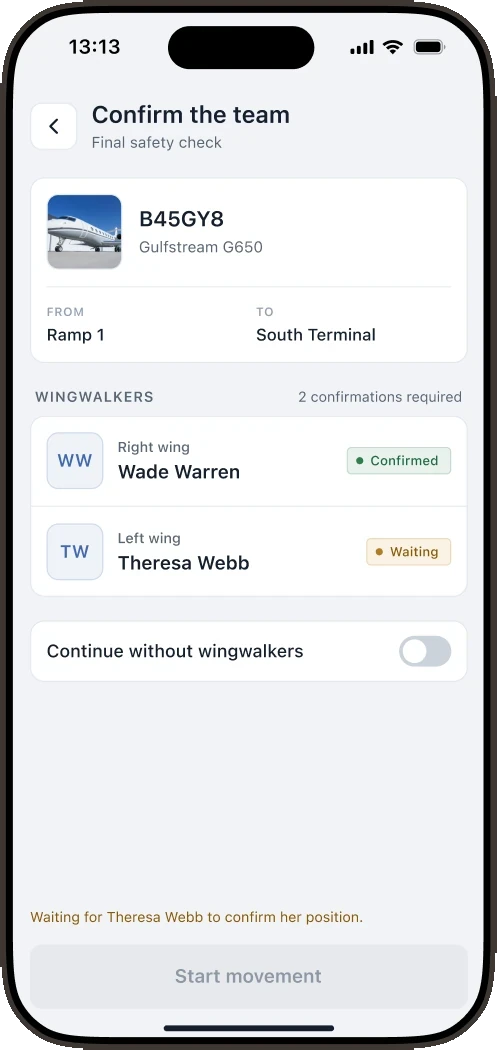

Confirm the team: wingwalkers assigned, one has confirmed their position, the second is still waiting

Assignment and confirmation

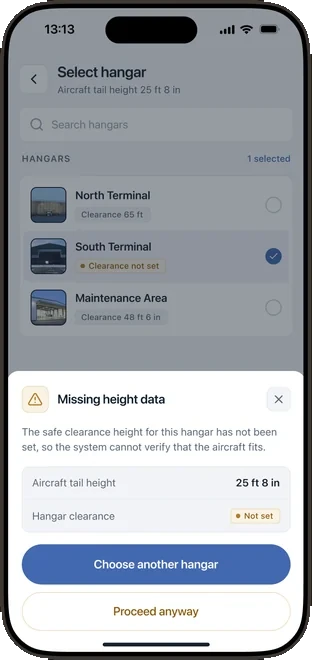

Missing height data: the aircraft tail height is known, the hangar clearance is not set, with Choose another hangar and Proceed anyway actions

Fragment of the warning when data is missing.

Branch when choosing a hangar

Unknown height is a separate state

I separated missing data from a dangerous clearance: I put the aircraft height next to the missing hangar data and explained why the comparison is not possible.

Instead of a silent "safe" or an automatic block: a warning and an explicit choice. The cost: the crew can continue, but the system does not confirm a safe clearance and does not prevent a wrong decision.

Completion

The employee confirms completion

The timer shows the duration; Finish movement explicitly ends the tow and changes its status. The cost: the employee has to take one more action, and without it the operation stays unfinished.

Mobile → web

The manager needs the result of the operation

The aircraft, the route, the participants and the completion time have to belong to the same tow. That is what makes it possible to reconstruct the work from the record.

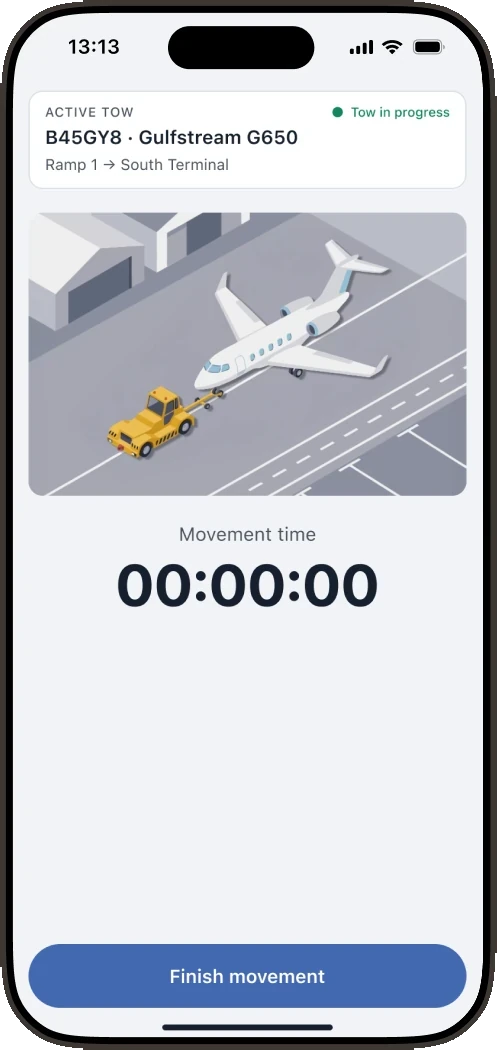

Active tow: the duration timer and the Finish movement button

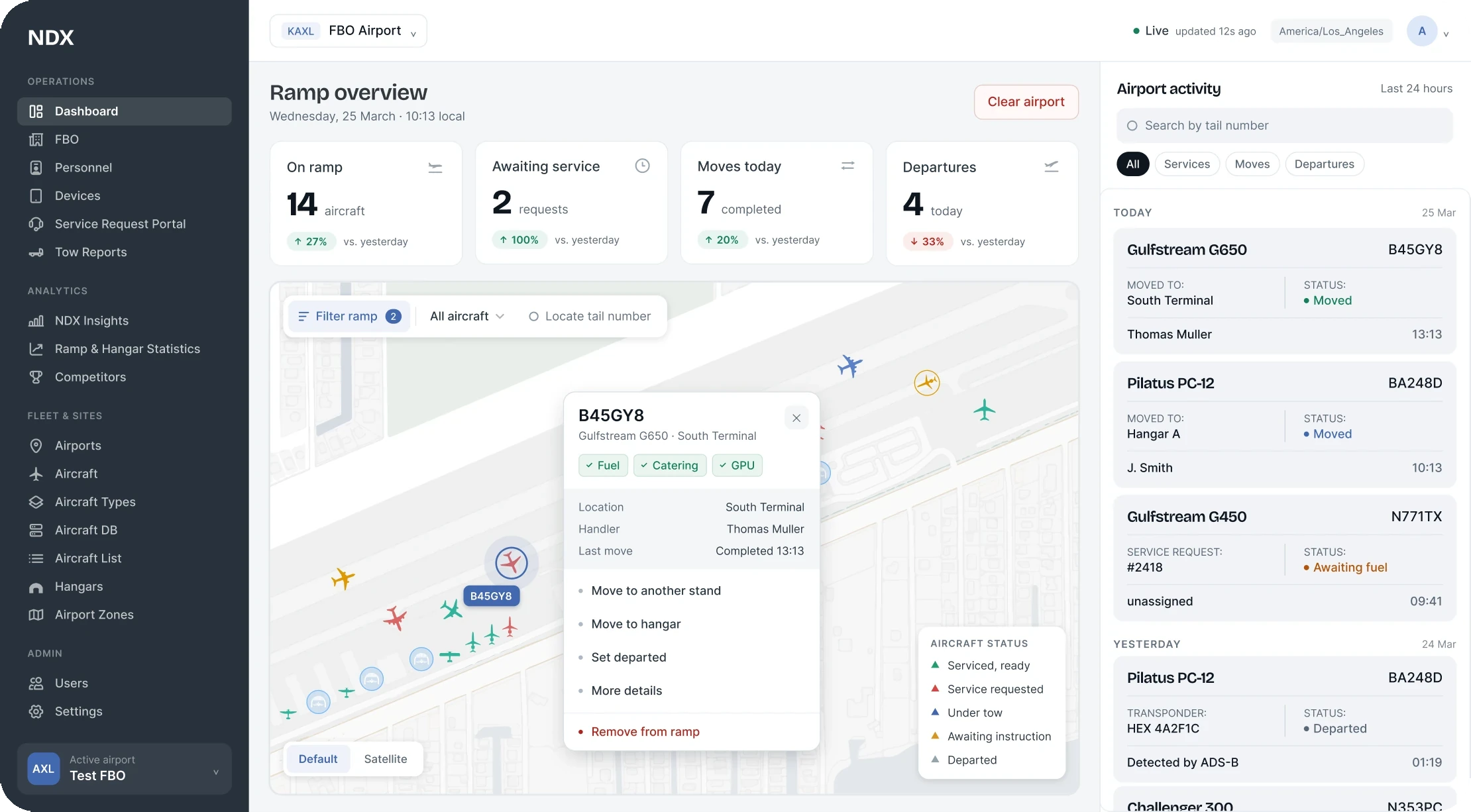

GroundOps · Ramp overview: the completed B45GY8 tow in Airport activity, South Terminal, Thomas Muller, 13:13

03

Inspection finished, problem still open

From 2022 I designed Inspections: fuel quality checks to the ATA 103 standard and ground equipment inspections. The main requirement for the model: finishing an inspection must not close the work on a fault that was found. I connected the inspection, the problem and the steps that follow.

Inspection flow

01

Choose the inspection

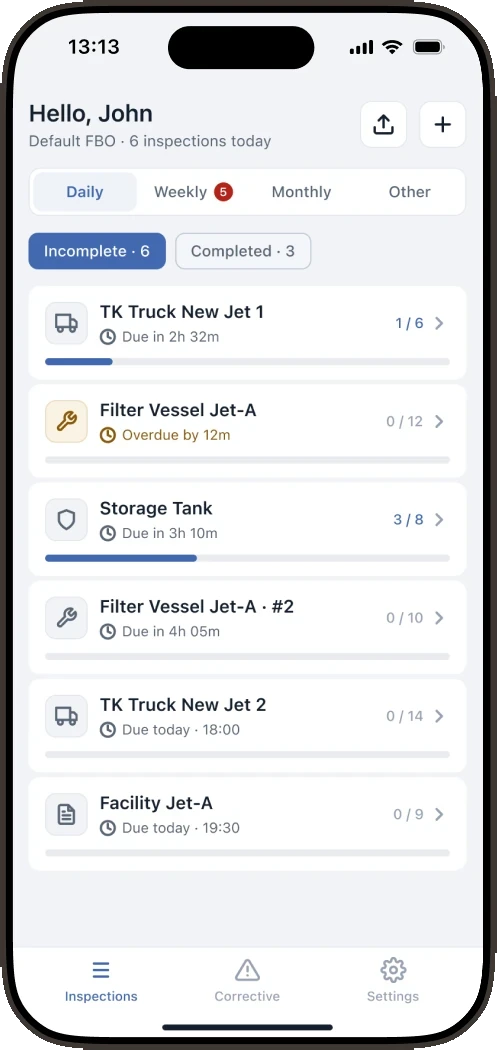

Inspection list: Incomplete and Completed statuses, due dates and progress for each check

Working material: statuses and the confirmation method are already visible in the list.

02

Confirm the equipment

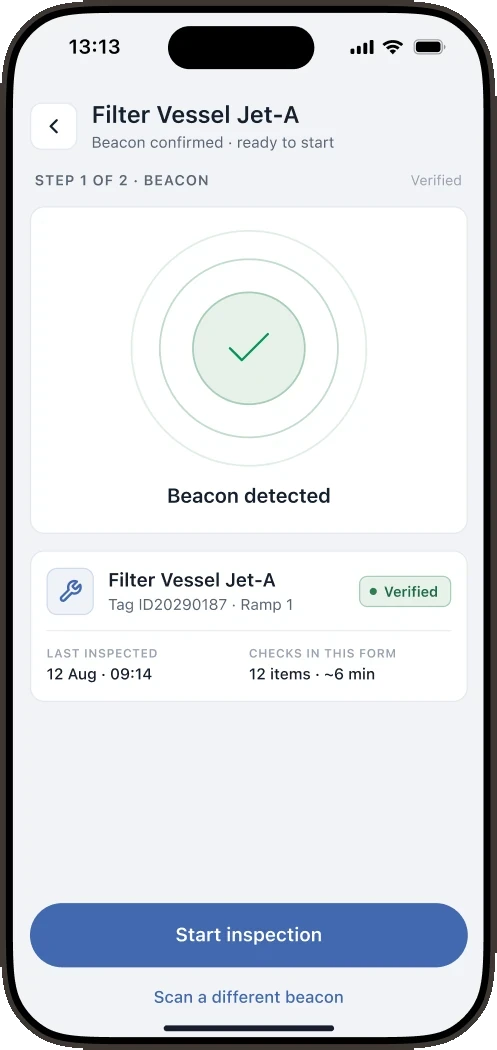

Beacon detected: the tag has confirmed the selected Filter Vessel Jet-A equipment

Reading the tag confirms the selected equipment. It does not prove the quality of the inspection.

03

Prepare for submission

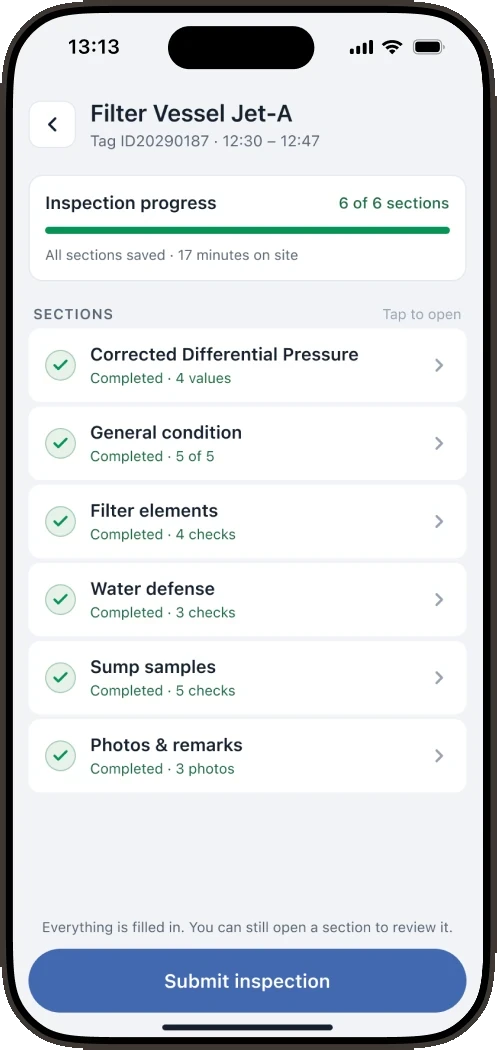

All inspection sections are filled in and the Submit inspection button is active

The completed sections are gathered before submission; this screen does not yet confirm that the result is saved.

Offline inside the main flow

Saved ≠ submitted

Inspections works without a connection. A result saved locally is not yet visible to the manager on the web; it appears there after a successful upload. These states cannot be shown the same way.

01

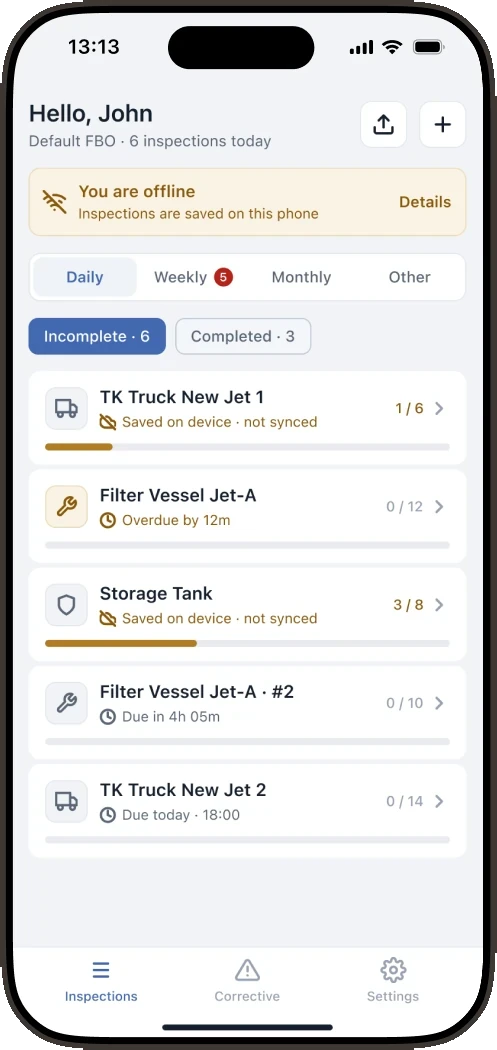

Connection lost

You are offline banner: records marked as saved on the device only

The banner reports the offline state and marks the records saved on the device only.

02

What happens to the data

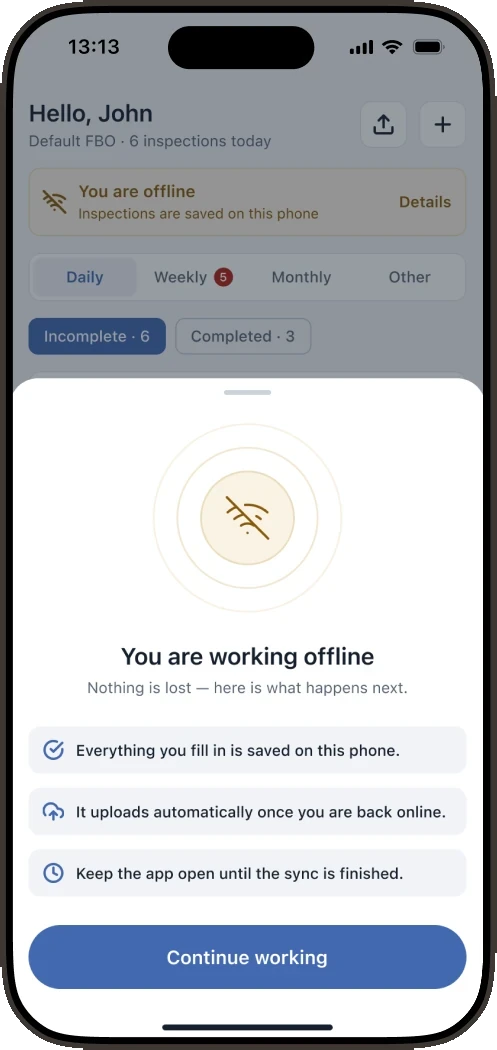

You are working offline screen: an explanation of automatic upload and the Continue working button

The explanation separates local saving from uploading and lets the work continue.

03

Sync queue

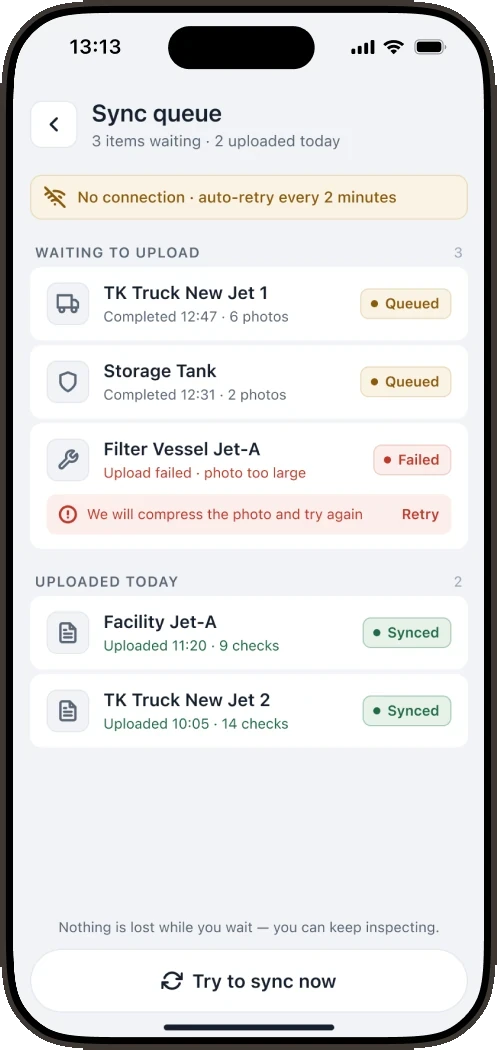

Sync queue: records with Queued, Failed and Synced statuses

Queued, Failed and Synced show what is waiting to upload, where a retry is needed and what is already uploaded.

If a discrepancy is found

A record of the problem

Stays open after the inspection is finished.

Work on the fix

Description, actions and history for the same equipment.

If taken out of service

A separate inspection is required before it returns.

Decision

Continue work that is already open

On the next inspection the employee can run into the same problem. I showed the existing corrective action right inside the check: description, date, comment and files.

Continuing the inspection and working on the problem are different actions. That adds a step, but it keeps the context: finishing the form does not close the discrepancy.

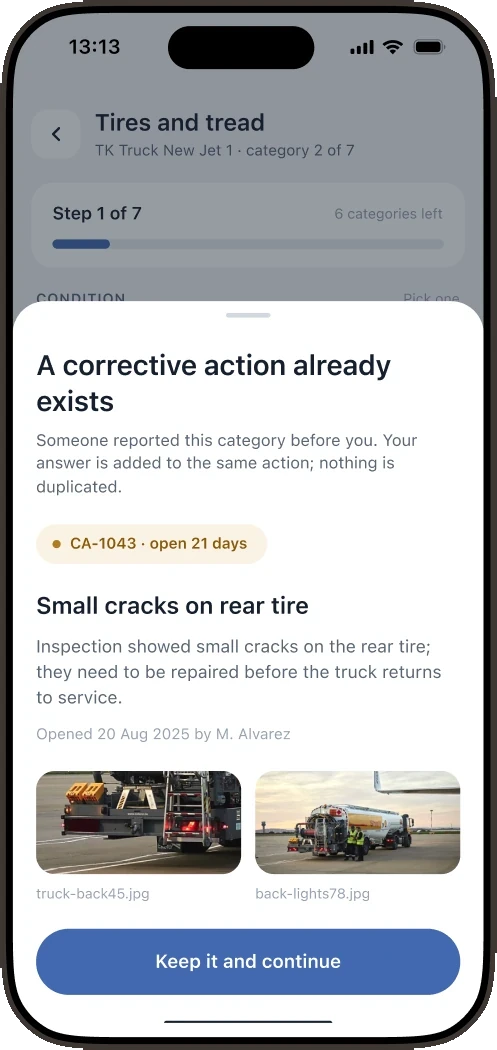

Mobile inspection: the existing CA-1043 corrective action about small cracks on the rear tire, with Open CA-1043 or Keep it and continue

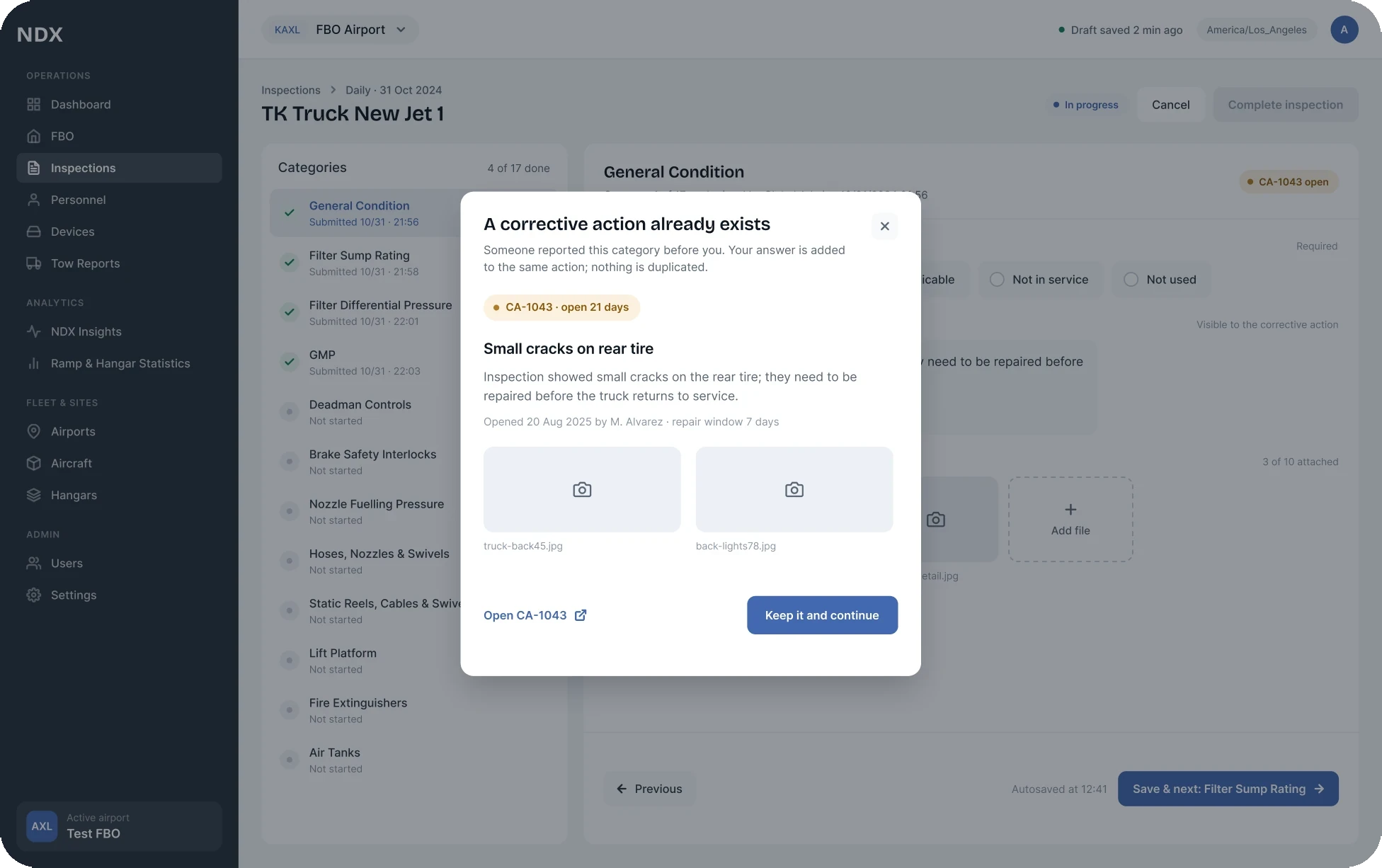

Web inspection of the same equipment: the A corrective action already exists modal showing record CA-1043
Returning equipment

After the fix, a separate return inspection is required

On the web the equipment stays in the queue until the Return to Service inspection is finished. This is a separate step after the problem is fixed. The cost: an extra inspection; in return, the manager sees that the equipment cannot be treated as ready for work yet.

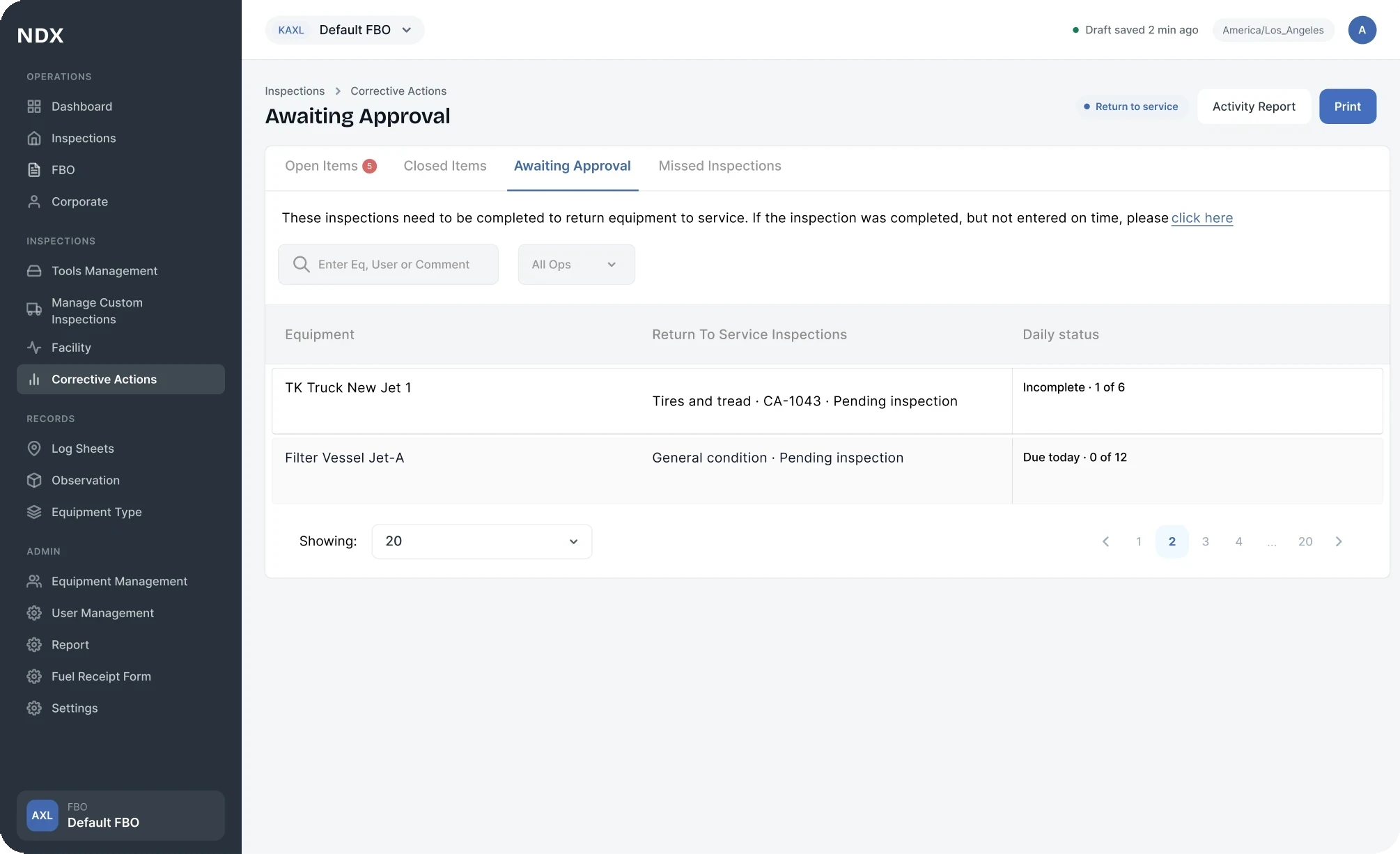

Corrective Actions · Awaiting Approval: equipment waiting for a Return to Service inspection, including record CA-1043

The screen is assembled from the working Awaiting Approval structure and the current navigation; the row data is anonymized.

04 · Contribution and outcome

Designed personally

The early Ramp concept (the future GroundOps), the key GroundOps flows, the structure of Inspections and the link between mobile work and the web.

Kept it consistent

Shared rules for forms, tables and statuses. I reviewed other designers' work and worked through exceptions with engineers and QA.

Team responsibility

I worked on the Axel team as an external product designer for NDX. Requirements and feedback from the sites came through the product lead; there was no constant direct access to operators. Product and engineering set the technical direction. I was responsible for the flows and the interfaces.

Adoption

External confirmation of scale

Signature selected Inspections for its US network after evaluating the product. This confirms demand for the solution and is a result of the whole team; it does not measure my personal contribution alone.

Announcement ↗
Industry link

The NATA program

NDX acts as a technology partner for the NATA fuel quality control program: digital inspections, corrective actions and records for audit. This confirms that the model is relevant to the industry.

Program ↗
Limits of the outcome

Without access to operational analytics I cannot confirm fewer errors or time saved. To evaluate the decisions I would check how complete the tow records are and how long problems take to resolve, while watching the time it costs employees and the upload failures.

What I would test next

With operators I would test two things: whether it is clear that an unknown height does not mean a safe clearance, and whether they distinguish finishing an inspection from fixing the problem.
